Skip to content

Portfolio Overview

Risk quantification is the backbone of AI governance in Modulos. It turns “what could go wrong” into a monetary decision signal you can prioritize, budget, delegate, and audit.

Where in Modulos

Use these views to understand and manage risk exposure:

  • Organization → Risk Management → Risk Overview for portfolio rollups and top risk drivers
  • Organization → Risk Management → Risk Limits and Project Risk Limits for appetite and budgets
  • Project → Risks to add risks, select threats, and run quantification

For a full operating map and permissions model, see Operating Model.

Permissions

  • Organization risk configuration is typically managed by the Organization Risk Manager role.
  • Quantification runs are typically started by the Project Owner role.

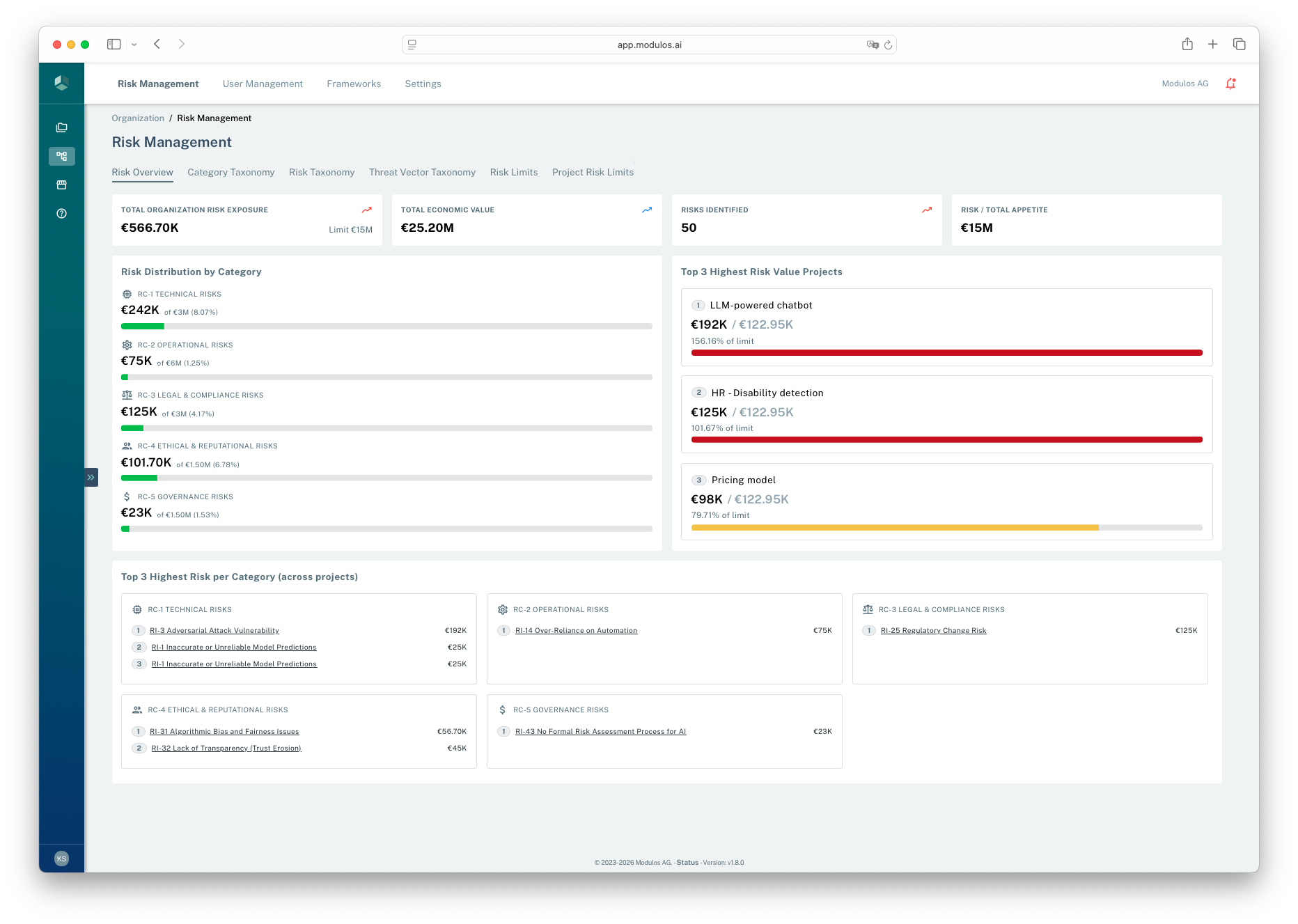

Risk Management overview dashboard showing total exposure, category distribution, and top projects.
The Risk Management overview provides a portfolio view of exposure and the projects driving the most risk. UI shown in light mode.
  1. 1
    Where you are
    Organization-level Risk Management gives you a portfolio view.
  2. 2
    Exposure summary
    Monitor total exposure and how it compares to appetite.
  3. 3
    Top drivers
    Identify which projects contribute the most to portfolio exposure.

What this is

Risk quantification is not risk avoidance. It makes risk explicit so leaders can decide what to accept, what to treat, and what to stop.

When risk stays qualitative, governance often becomes a veto without substance. When risk is monetary, it becomes a decision conversation: expected loss, risk appetite, and the cost of mitigation.

Quantification also enables speed:

  • stage-gate decisions become explicit and repeatable
  • teams can delegate decisions within defined risk thresholds
  • “too risky” becomes a hypothesis you can challenge and refine

How it works

In Modulos, risks roll up from threats:

text
Expected loss = Σ (rate × damage)
  • Rate: how often the threat becomes an incident.
  • Damage: the monetary loss per incident.

This decomposition is the point. It tells you where risk comes from and what mitigations should target.

Platform objects and rollups

  • Organization taxonomy: shared categories, reusable risks, reusable threat vectors.
  • Project risks: taxonomy risks selected into a project scope.
  • Risk threats: project-specific instances of threat vectors.
  • Quantification runs: method, inputs, outputs, status, and one monetary value per threat.
  • Rollups and limits: threat → risk → project → category → organization.

Risk appetite and limits

Quantification becomes actionable when it’s connected to appetite and delegation.

In the current platform model:

  • organizations set a total monetary risk appetite
  • categories define percentage shares of that appetite and must sum to 100%
  • projects have risk limits that must sum to the organization appetite
  • within each project category budget, individual risk limits must add up consistently

If limits do not add up consistently, Modulos surfaces warnings and blocks quantification until configuration is corrected.

Portfolio reality

Summing expected loss is a useful starting point. In real organizations, risks can be correlated through shared vendors, shared foundation models, and shared infrastructure. Use scenario analysis and dependency awareness for concentrated exposures.

How to use this

1

Set appetite

Define a total risk budget and category shares

2

Adopt the taxonomy

Start with the default library and add domain gaps

3

Quantify the top threats

Pick 1–3 threats per key risk and estimate expected loss

4

Treat and re-quantify

Invest in mitigations, then re-run as systems and data change
